Uninterrupted production during mooring line top wire replacement

13 Feb 2024

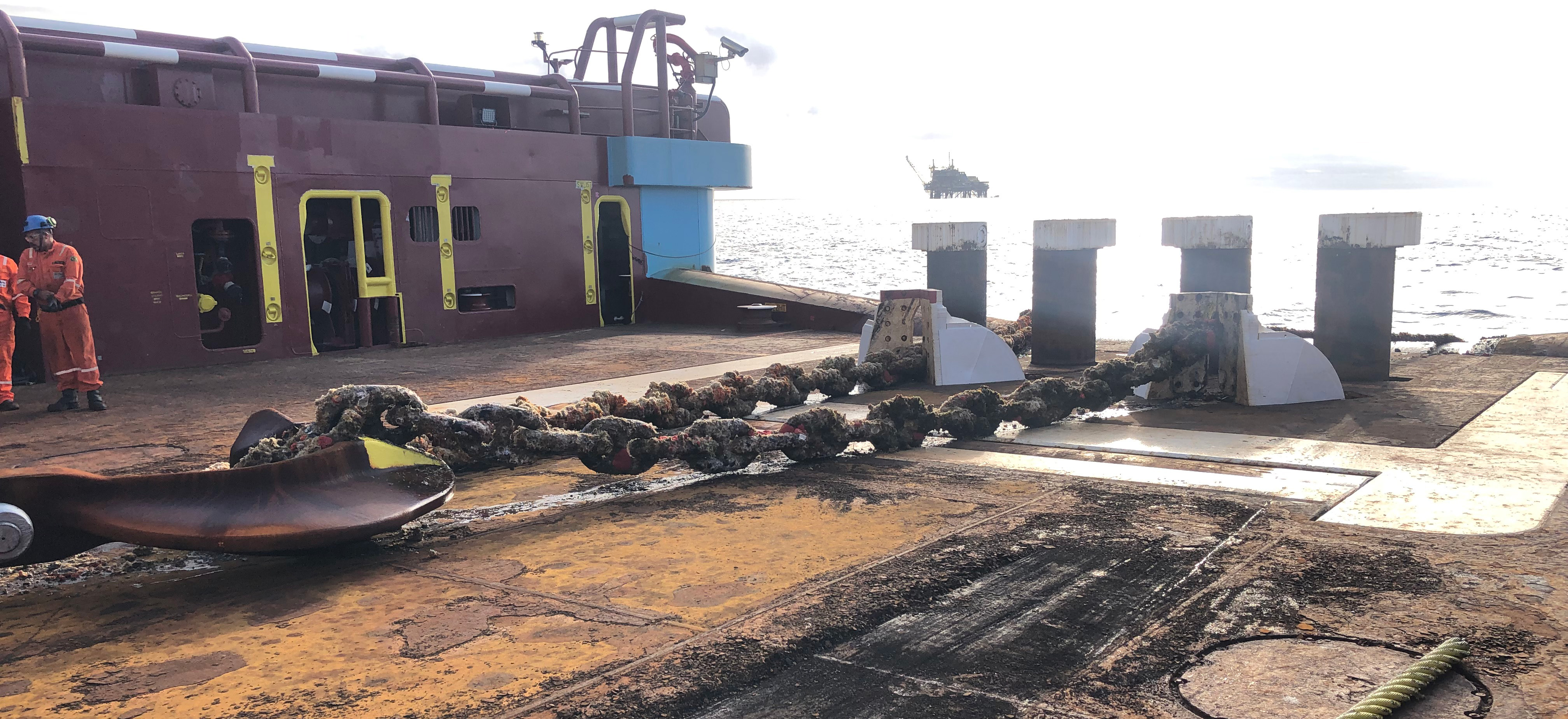

Intermoor completing mooring line top wire replacement work for a platform in the Campos Basin offshore Brazil

Project overview

Project name

Campos Basin

Location

Offshore Brazil

Developer partners

Major oil and gas operator

Water depth

150 m

Solution

Mooring line replacement

Intermoor, Acteon’s Mooring and Anchors business line, replaced a damaged top wire on an offshore platform in Brazil, delivering a full project scope including engineering, fabrication, and offshore operations.

Safe execution around legacy infrastructure

Working carefully near an active, ageing platform in a congested field, we ensured safe and uninterrupted production in the face of difficult working conditions through efficient logistics, careful planning and custom-designed equipment.

Precision-engineered mooring replacement

We delivered the full scope of work for this time-sensitive operation: designing and fabricating bespoke equipment, mobilising from our Porto do Açu facility, and managing the entire offshore campaign. The work took place on a 57-year-old platform used for water separation, requiring the team to work with caution in close proximity to operating infrastructure.

Challenges included winch speed limitations, restricted weather windows, and the need to avoid any interruption to production. A bespoke 95-mm H-Link mooring connector was fabricated for the job, and a 150-te spooling machine was mobilised to support offshore operations.

Our pre-project coordination with multiple suppliers ensured readiness at every stage. The suitability of the anchor handling tug supply (AHTS) vessel was confirmed in advance, and marine growth was cleared using third-party hydroblast equipment. All crew, including port and installation personnel, were briefed in detail to ensure a seamless operation.

Drawing on our global experience and local infrastructure, we completed the offshore operation in just 45 hours - enabling the operator to meet integrity targets without disruption. The project’s success led to follow-on work, including the development of a mooring incident response plan.

Innovations in action

  • Designed and delivered a bespoke 95-mm H-Link in-house, ensuring quality control and quick turnaround
  • Used a 150-te spooling machine to handle the replacement wire
  • Streamlined logistics and enabled rapid deployment by staging all equipment and personnel through our Porto do Açu facility

The result

We safely and efficiently replaced the damaged top wire in under two days, despite operating next to a live, ageing platform in a constrained area. The project was executed without disrupting production, showcasing our ability to coordinate complex logistics and deliver precision-engineered solutions in live offshore environments. The operator awarded follow-up work, confirming confidence in our capabilities.

Related case studies

Explore more mooring integrity management projects

Case Studies

01 Jul 2025

Innovative chain replacement method supports Bonga’s life extension project

Intermoor replaced the top chain on all twelve mooring lines (four groups of three) of the Bonga FPSO, located 120 km southwest of the Niger Delta.

Case Studies

14 May 2025

Fast and reliable mooring line repair on an FPSO

Intermoor carried out a successful emergency mooring intervention on a 10-year-old Floating Production Storage and Offloading (FPSO) offshore Brazil.

Case Studies

28 Jan 2025

Complex FPSO top chain replacement completed safely and efficiently

Intermoor supported a major North Sea FPSO with mooring maintenance, replacing top chains and winch wire coordinating SIMOPS across four vessels - minimising risk, downtime, and environmental impact.

Speak to our team

Our team of experts will design a solution that fits the technical, environmental and commercial demands of offshore projects.
